On 1 January 1848 Samuel U Roberts CE was appointed District Engineer of the Districts of Loughs Corrib, Mask and Carra in the counties of Galway and Mayo. He spent the early part of that year in “making the necessary preparations and arrangements” and began operations on navigation works in Galway on 8 March, having taken possession of some of the land required for the Eglinton Canal.
In his report to the Board of Public Works for 1848 [Seventeenth Report from the Board of Public Works, Ireland, with Appendices HMSO, London 1849], he covered the start of work on the tidal basin at the Claddagh:
A large quantity of ashlar stone has been prepared for the lock and tidal basin works, in connexion with the canal, and some stanks have been formed with a view to carrying on the works as easrly as the approaching season will permit.
In the following year’s report, he said:
The exterior wall of the tidal basin has been completed, and a secure lining of puddle carried round the whole work. The site of the tidal lock and basin has been enclosed, and the necessary excavation is now progressing.
I don’t have a copy of the nineteenth report of the Board of Works, but in the twentieth, covering 1851 and published in 1852, Roberts said:
The lock which forms the entrance from the sea to the tidal basin has been built during the last year, the gates and sluices erected, and everything in connexion therewith perfected. The cofferdam enclosing the site of the lock has also been removed, and a great portion of the timber subsequently used as centering for the new West Bridge. The progress of that portion of the tidal basin extending from the causeway formed in connexion with the Claddagh wooden bridge up to the lock at Folan’s Lane has been a work of peculiar difficulty. The channel here is narrow, and it has been necessary to provide for the discharge of the tail-waters of three mills, in addition to which the tides which at high water percolated through the made ground on every side rendering it a matter almost of impossibility to unwater the work. The excavation of the western side of this portion of the basin has been completed, the Claddagh quay underpinned, and the quay wall between Balls Bridge and the lock at Folan’s Lane raised to the full height, and the trackway formed.
Finally, in the twenty-first report, covering 1852, Roberts was able to announce the completion of the work on the basin:

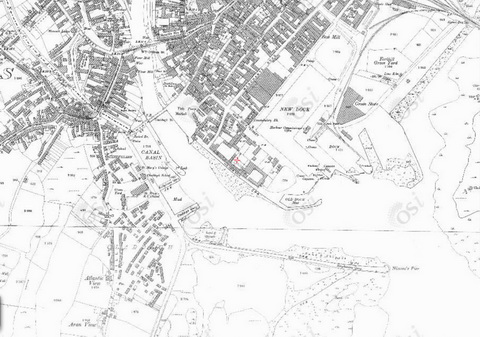

These [navigation] works, with the exception of some excavation between the Tidal Basin and Folan’s-lane Lock (which cannot be executed until the mill-works in that locality are in progress), and the dredging of a shoal at the head of the canal, were completed in September, and the navigation was opened by the late Lord Lieutenant, Lord Eglinton, on the 20th August.
Happily, his lordship did not organise a tournament to mark the occasion.
In Lough Corrib, its shores and islands: with notices of Lough Mask [McGlashan & Gill, Dublin 1867], Sir William R Wilde MD quoted a letter from Roberts giving the dimensions of the basin:
[…] the length of the Ship Canal is two-thirds of a mile; at the entrance is a tidal basin, 470 feet long, and 170 feet wide, with 1000 feet in length of quayage. The ascent from this basin to the level of the lough [Corrib] is accomplished by one lock, 130 feet long, and twenty-one wide, with a lift of fourteen feet. The depth of the navigation is six and a half feet.

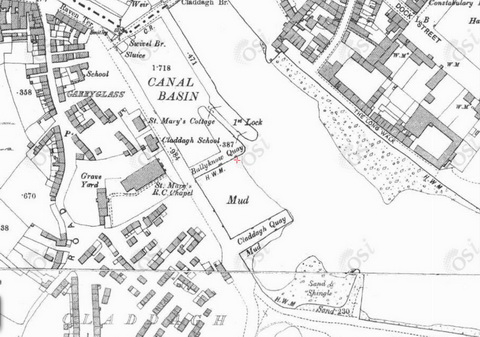

The basin in close-up (OSI ~1900) Here are some photos taken in early 2014.

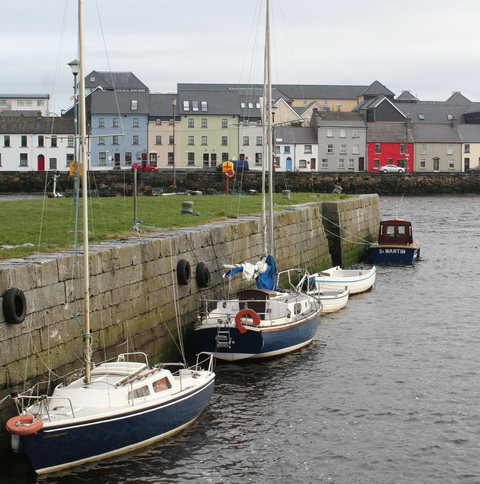

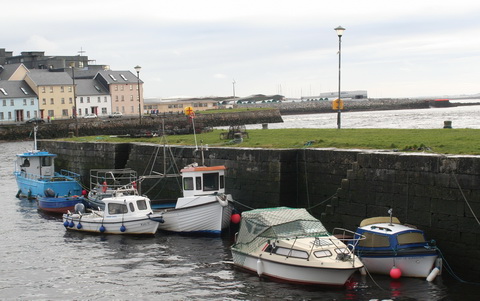

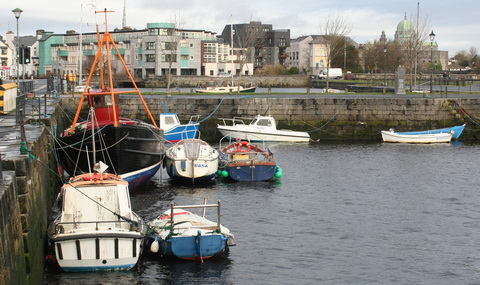

The basin

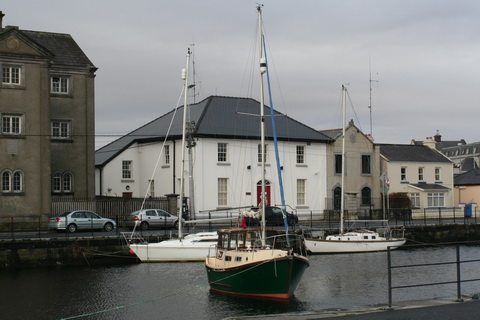

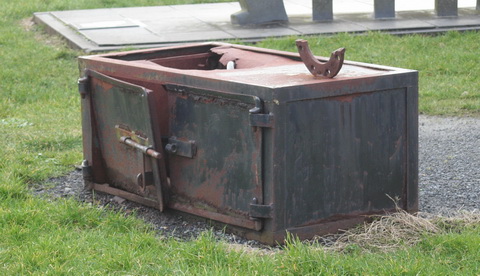

The Corrib Navigation Trustees

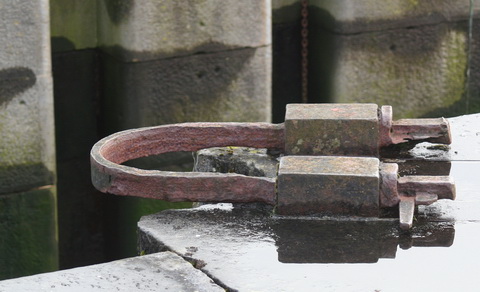

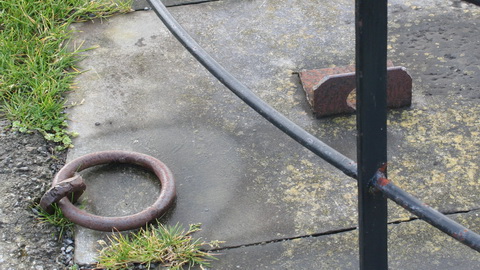

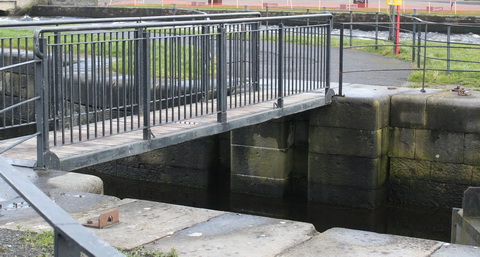

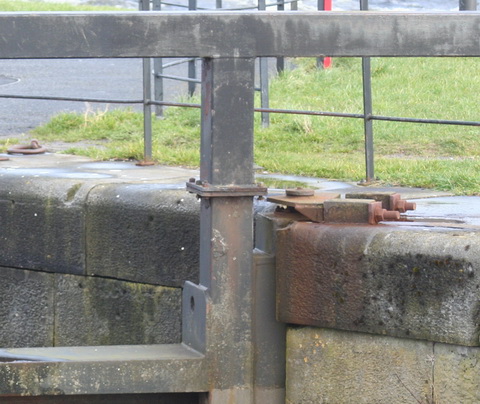

The lock

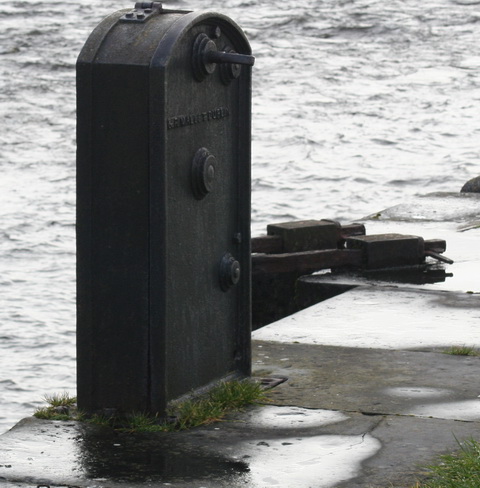

Only the upper gates remain so the lock can be used only when the water level outside the gates matches that inside. I gather that boats are admitted in the autumn and released in the spring

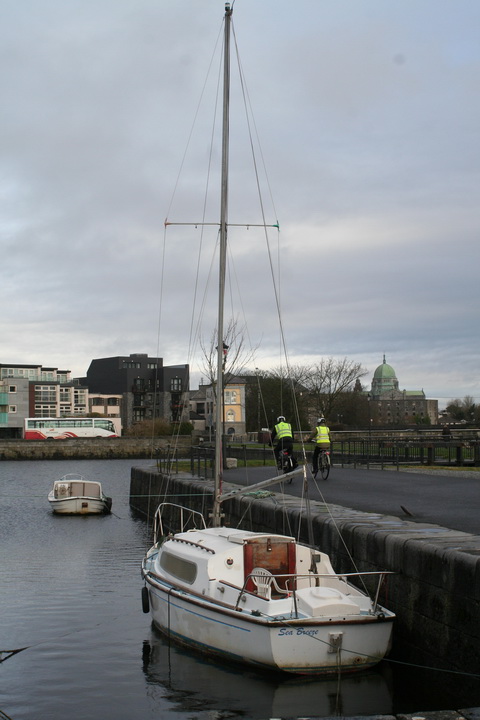

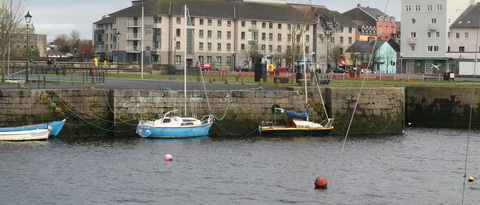

Outside the basin

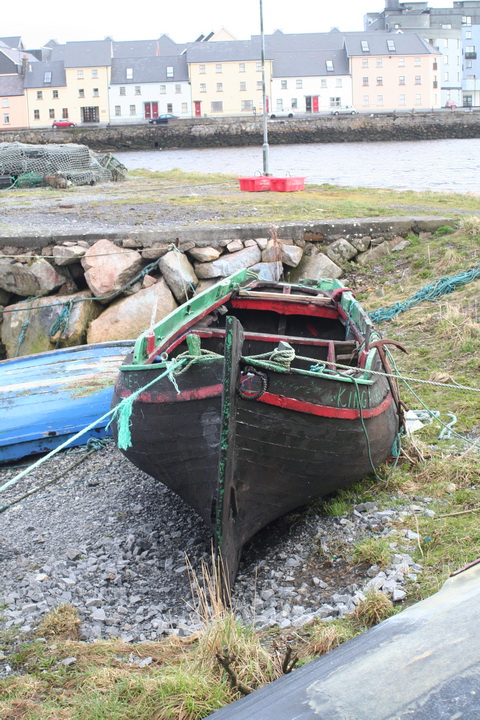

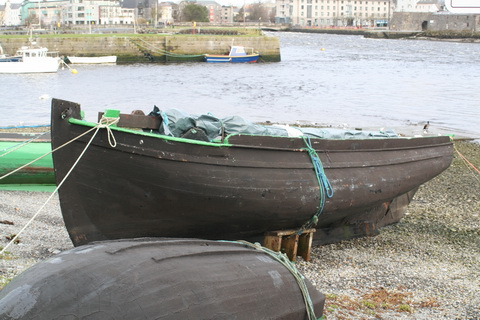

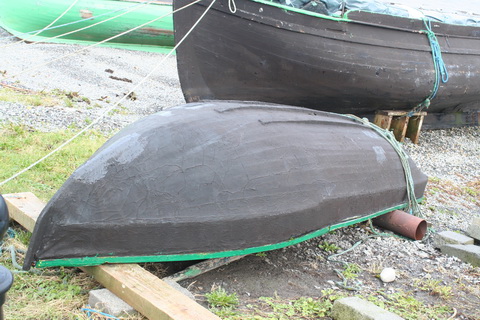

I would welcome corrections on anything I’ve got wrong, especially the identification of the traditional boats.
